Conclusion: New Leverage for Nvidia’s Standards, a New Test of Suppliers’ Pricing Power
Nvidia unveiled DSX POD at GTC Berlin, moving multi-rack assembly, cabling, liquid-cooling integration and validation into the factory before shipping the modules for on-site deployment. The approach addresses real problems in data center construction: a shortage of skilled crews, the difficulty of mobilizing workers across locations, and the complex coordination of trades and testing. Bringing equipment online sooner also allows it to start delivering services sooner, reducing the capital tied up during the wait and the risks of integration.
But standardization has long been a point of tension between Nvidia, its customers and its suppliers. Customers want to retain control over their architectures and customization options. Suppliers have an incentive to preserve design differentiation, the extra margins that customized products can command, and their bargaining power. The deployment and financial benefits of DSX POD could give Nvidia more leverage to promote common specifications, shifting the balance in these negotiations. In component markets with many competitors and readily interchangeable products, a larger share of standardized designs could put further pressure on suppliers’ margins.
As of 2026/10/24, when this article was completed, major cloud customers had yet to appear on Nvidia’s announced DSX POD partner list, and no clear public statements of adoption had emerged. Whether these customers will accept Nvidia’s new specifications and standardized deployment model in exchange for getting online sooner remains worth watching. Their decisions will also affect Nvidia’s negotiating position with suppliers and who ultimately captures the gains from greater efficiency.

DSX POD: Moving On-Site Integration into the Factory to Target a Quarter-Earlier Launch

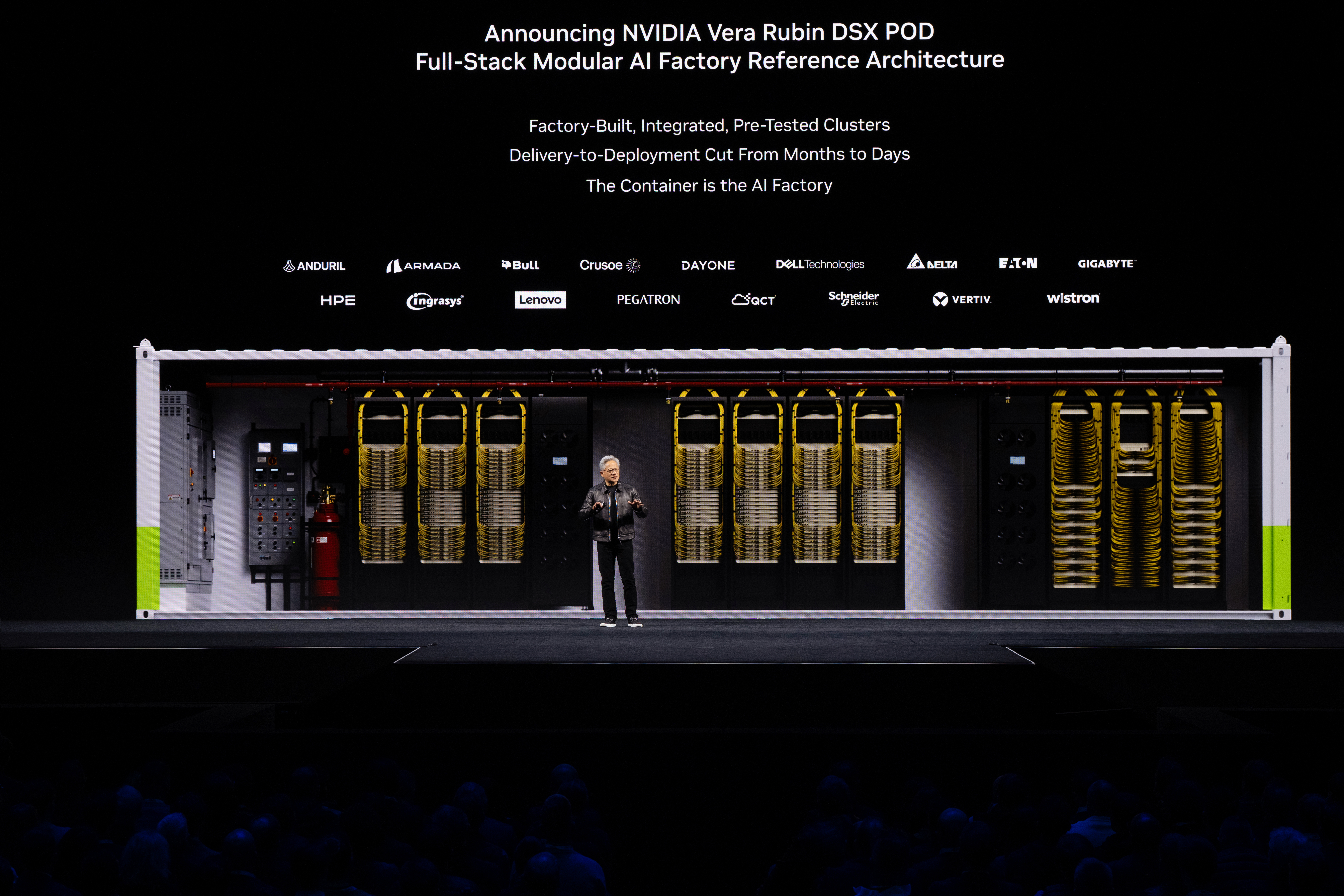

In his GTC Berlin keynote, Jensen Huang first revisited how Nvidia moved assembly of complete NVL72 racks upstream into the supply chain, then introduced DSX POD as an extension of factory prefabrication to multiple racks.
DSX POD takes that approach a step further. Huang noted that even fully assembled racks can still require months of integration after reaching the site. If system integration, testing, validation and burn-in can also be completed within the supply chain, the equipment can leave the factory as a working unit.
Nvidia’s technical article explains that DSX POD integrates compute racks, networking, rack power, liquid cooling and cabling into containerized modules at a manufacturing facility, with validation completed before shipment. While the factory handles this work, the site can proceed with grading, foundations, power and external connectivity. Once the modules arrive, crews position them, connect them to one another and complete final testing. The two streams of work no longer have to run entirely in sequence.
How much faster could this be? Huang said that the time from the arrival of compute equipment to token generation could fall from roughly four or five months to one month. The official press release claims deployment could shrink from six months to as little as 14 days once site power, cooling, networking and other supporting infrastructure are ready. That is not the total time required to build a data center from site selection to completion.
Huang’s explanation of the economics was straightforward: if a facility could generate $40 billion in annual revenue, coming online a quarter later would mean forgoing roughly $10 billion in revenue during that period. This was an illustration of the value of time, not a revenue forecast for every data center. But it captures the point: when equipment has already been paid for and is still waiting for integration and activation, the cost of delay extends well beyond a few extra months of construction expenses.
DSX POD Targets the Labor Bottleneck in On-Site Data Center Assembly
The need is not simply a claim made by Nvidia. Turner & Townsend’s 2026–27 Data Centre Construction Cost Index surveyed 401 industry respondents. Of those, 81% described the availability of skilled labor for data center projects in their region as moderately or highly constrained. Mechanical, electrical and plumbing trades were particularly sought after.
A more direct view of construction crews comes from the AGC and NCCER contractor survey conducted in July and August 2026. Among respondents that had worked on data center projects during the preceding year, 58% said those projects had intensified competition for skilled workers, while 49% reported greater wage pressure.
In the “biggest challenge” question in the data center survey tables, 37% of 210 valid responses selected the availability of workers or subcontractors, the highest share among the listed options. Other answers included no significant challenges, local opposition, supply chain delays, regulations, power and water. This offers stronger evidence than an isolated project example that access to qualified crews is a practical constraint on contractors’ ability to deliver.
These surveys show that the difficulty is not just finding enough people. It is assembling the right crews at a specific place and time to complete interdependent tasks. If factory prefabrication, validation and the handoff to the site proceed as planned, DSX POD can reduce the need to mobilize and coordinate crews for on-site assembly. That efficiency is also tied to standardization: the more a design can be reused, the more readily factory prefabrication can deliver its benefits.
Multiple Constraints on Data Center Construction
Skilled labor availability
Respondents describing local skilled labor availability as moderately or highly constrained.
Supply chains for new cooling technologies
Respondents describing local supply-chain support as moderately, highly or severely constrained.
Access to power
Respondents identifying access to power as a major barrier to successful delivery.
Source: Turner & Townsend, Data Centre Construction Cost Index 2026–27.
Data Center Delivery Challenges: The Contractor’s View
Workers or subcontractors
The most frequently selected top challenge.
No significant challenges
Local opposition
Supply chain delays
Regulatory delays
Access to power
Access to water or water treatment
Data center subsample: 223 respondents; Q16: 210 valid responses. Survey conducted July–August 2026. Contractor responses may not fully capture projects stalled before construction. Source: AGC/NCCER 2026 Workforce Survey, Data Center, Q16 (PDF page 7).
DSX POD’s Price Tag Points to Large Cloud Operators as the Main Buyers
The DSX POD configuration Huang presented contains seven liquid-cooled Vera Rubin NVL72 compute racks, totaling 504 GPUs. This is far beyond buying one or two servers; it is an integrated deployment unit spanning multiple racks. Nvidia’s initial positioning likewise targets large-scale, new-build, liquid-cooled AI infrastructure, including Nvidia Cloud Partners expanding capacity at scale.
One estimate puts the potential price of a Vera Rubin NVL72 rack at $9.1 million. If that estimate holds, seven racks would come to $63.7 million, before integration beyond the racks, external power and cooling, site construction, transport and installation.
Buyers with that kind of spending power are most likely to be large cloud service providers (CSPs), neoclouds and major AI labs.
Major Cloud Customers Are Absent from the Initial Partner List
Nvidia’s initial partner list primarily consists of companies that manufacture, integrate and supply the solution. On 2026/10/21, Nvidia announced that it was working with 17 companies: Anduril, Armada, Bull, Crusoe, DayOne, Dell Technologies, Delta Electronics, Eaton, Foxconn subsidiary Ingrasys, GIGABYTE, HPE, Lenovo, Pegatron, Quanta subsidiary QCT, Schneider Electric, Vertiv and Wistron. Worldwide deliveries are expected to begin in early 2027. The group is dominated by computing systems, manufacturing, integration and infrastructure providers, but also includes companies such as Crusoe and DayOne that operate cloud or data center businesses.
Among them, Crusoe’s announcement on the same day described its 352,000-square-foot Spark factory in Brighton, Colorado. Its Spark platform will support DSX POD, with next-generation liquid-cooled modules expected in 2027. This describes a partner’s manufacturing capabilities and plans, rather than evidence that DSX POD is already in volume production and delivery.
Still, are clearly identified construction problems and an attractive solution enough to persuade large customers to accept this standardized deployment model? Nvidia’s initial partner list leaves an interesting question.
As of 2026/10/24, CoreWeave, Nebius, Google Cloud, AWS, Microsoft/Azure and OpenAI were absent from that list. Nor had specific announcements been found setting out their DSX POD adoption volumes or deployment schedules.
If Huang wants to promote DSX POD, public backing from major customers would be a powerful endorsement. In other DSX software announcements released at the same time, CoreWeave, Nebius and Google Cloud were named as exploring the adoption of DSX MaxLPS dynamic power management software. CoreWeave and Nebius were also listed as evaluating new components of DSX OS infrastructure management software. In the OpenShell partnership announcement released at the same event, all of the major cloud companies mentioned above were named. These customers do appear in Nvidia’s announcements, yet similarly clear statements of DSX POD adoption have not emerged.
GTC BERLIN 2026 | Partnership Announcements
Major Cloud Companies in
GTC Berlin Announcements
| Company | DSX POD | DSX MaxLPS | DSX Flex | DSX OS New components | OpenShell |
|---|---|---|---|---|---|
| AWSCSP | |||||
| Microsoft /AzureCSP | |||||
| Google CloudCSP | |||||
| MetaAI / internet platform | |||||
| OpenAIAI Lab | |||||
| AnthropicAI Lab | |||||
| CoreWeaveNeocloud | |||||
| NebiusNeocloud |
Can the Financial Benefits of an Earlier Launch Shift the Balance Between Standardization and Customization?
How much AI server racks should follow common specifications, and how much customization should remain, has long been central to the struggle between Nvidia and its customers. The Information reported in 2024 that Microsoft and Nvidia had argued intensely over rack design for weeks. Customers want more than access to computing power; they also want to preserve their choices over data center architecture and design.
Nvidia has consistently sought greater standardization, encouraging customers to use common specifications to reduce the development and support burden created by individual customization requests. This also fits its “Speed of Light” approach to advancing product generations rapidly: the more a design can be reused, the easier it is to accelerate validation and delivery.
DSX POD could add a powerful bargaining chip to these negotiations. Customization can help customers fit equipment into existing facilities, retain their management practices or differentiate their services. But if common specifications allow a facility to come online several months earlier, the extra time required for customization becomes a more tangible opportunity cost. Huang’s example of $40 billion in annual revenue and $10 billion in a quarter illustrates precisely that value of time.
Chip delivery schedules could become another source of leverage for Nvidia. When a new chip generation is in short supply early in its rollout, earlier access can directly affect when a customer goes live. If Nvidia were to give DSX POD customers priority access to chips, that advantage, combined with the POD’s shorter deployment time, could further reduce the time from receiving equipment to launching services. This could strengthen Nvidia’s hand in pushing for standardization.
If DSX POD accounts for a rising share of new deployments, Nvidia could gain more leverage to promote standardization, and more suppliers may have little choice but to comply with common specifications.
Suppliers have been able to command higher prices through customer-specific designs, integration capabilities or specialized specifications. If more orders move to common designs, that room for differentiation could narrow. Standardization could also reduce development, production-line changeover and rework costs. Whether suppliers retain those savings or pass them on to customers through lower prices is a separate question of how the gains are shared.
The pressure could be greatest in component markets with many qualified suppliers and readily interchangeable products, where competition may become more focused on price, cost and delivery. For suppliers that depend on the extra margins from customization and face numerous rivals, a larger share of standardized designs could further squeeze both pricing power and profitability.
What remains to be seen is how much financial benefit DSX POD actually delivers to customers, and whether those benefits can increase its share of shipments for new AI infrastructure deployments. For Taiwan’s closely watched AI supply chain, changes in that share could also reshape how the gains are divided among Nvidia, cloud customers and suppliers.
Nvidia DSX POD:
New Leverage for Standardization
A New Test of Suppliers’ Pricing Power

Earlier deployment
Factory Prefabrication Addresses On-Site Labor Constraints
Moving assembly, cabling, liquid-cooling integration and validation into the factory reduces on-site mobilization and coordination. Earlier service delivery also reduces waiting time, tied-up capital and integration risk.

Customer choices
Will Major Customers Accept the New Specifications?
As of October 24, 2026, major cloud customers had not clearly announced DSX POD adoption. Their willingness to accept more common specifications in exchange for an earlier launch will influence Nvidia’s leverage and who captures the efficiency gains.

Negotiating specifications
A Larger Standardized Share Could Squeeze Suppliers’ Pricing Power
Customers want architectural and customization flexibility; suppliers want differentiation and bargaining power. As common specifications gain share, component suppliers facing many rivals and readily interchangeable products could see further pressure on margins.
